Selected work
Work products, not just project summaries.
Four projects show different parts of how I think: market validation, healthcare service economics, project scheduling and human-governed AI strategy.

01 · Confidential client engagement · Team Lead
U.S. Market Entry Strategy
Research moved the team from a broad U.S. expansion question toward a narrower credibility-first, relationship-led Texas pilot.
- 3 expert interviews
- 6-month pilot
- Warm-channel access

02 · Graduate healthcare venture
Mobile Diagnostics Venture
A clinic-hosted cardiac-diagnostics concept tested through an integrated 36-month model, break-even thresholds and a gated site rollout.
- 36 months
- C$400K staged seed
- Month 21 EBITDA-positive

03 · Project management · Assigned workstream
Reusable-Container Implementation Pilot

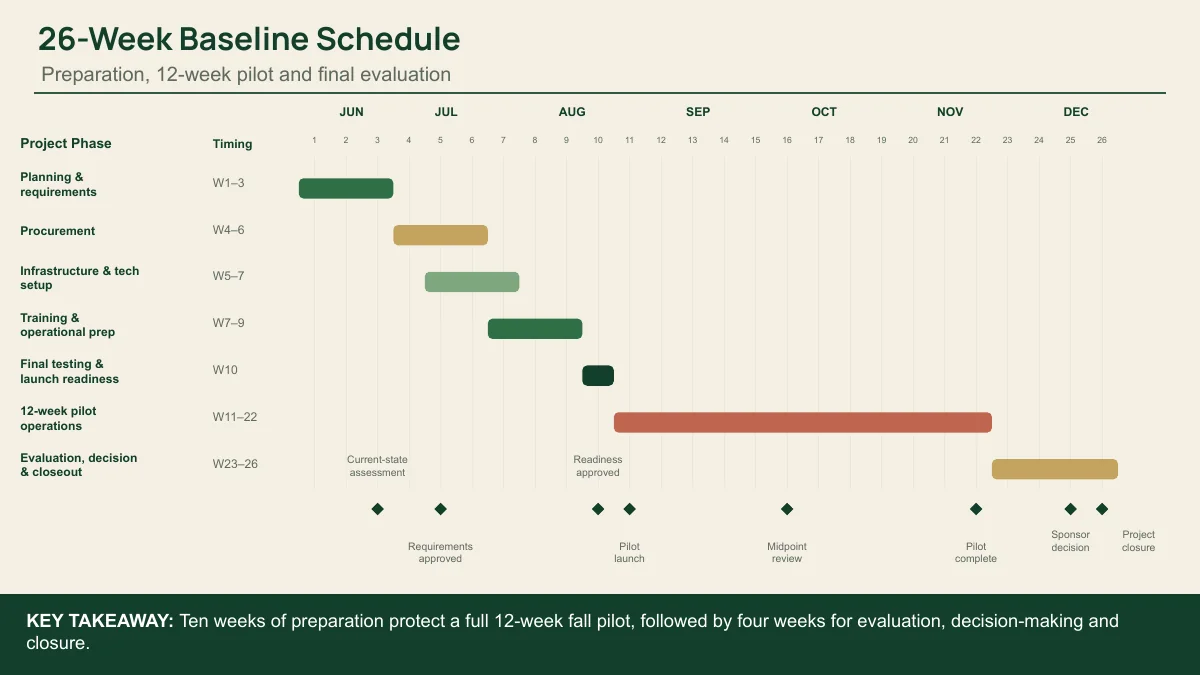

My workstream converted the project into a 3-level WBS, task list, baseline schedule, network logic and critical-path analysis.
- 26 weeks
- 50 activities
- 37 zero-float activities
- C$85K project cap

04 · Dean’s Cup · Team competition project
Optimus Edge

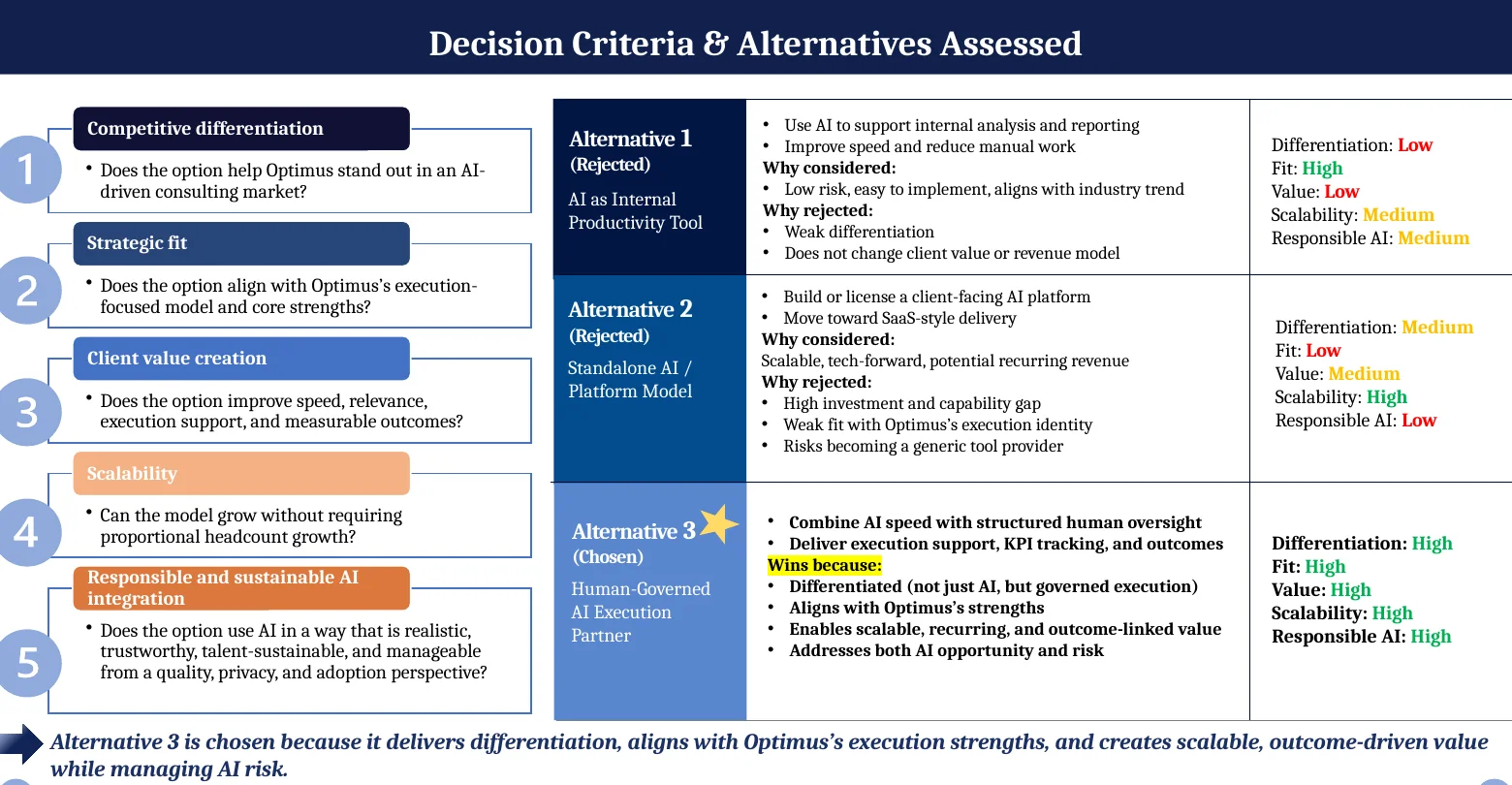

The team chose a human-governed AI execution model over a narrow internal tool or generic standalone platform, then designed governance and implementation around it.
- Top 6 finalist team
- 4-layer model
- 5-year roadmap
